Phases of Work

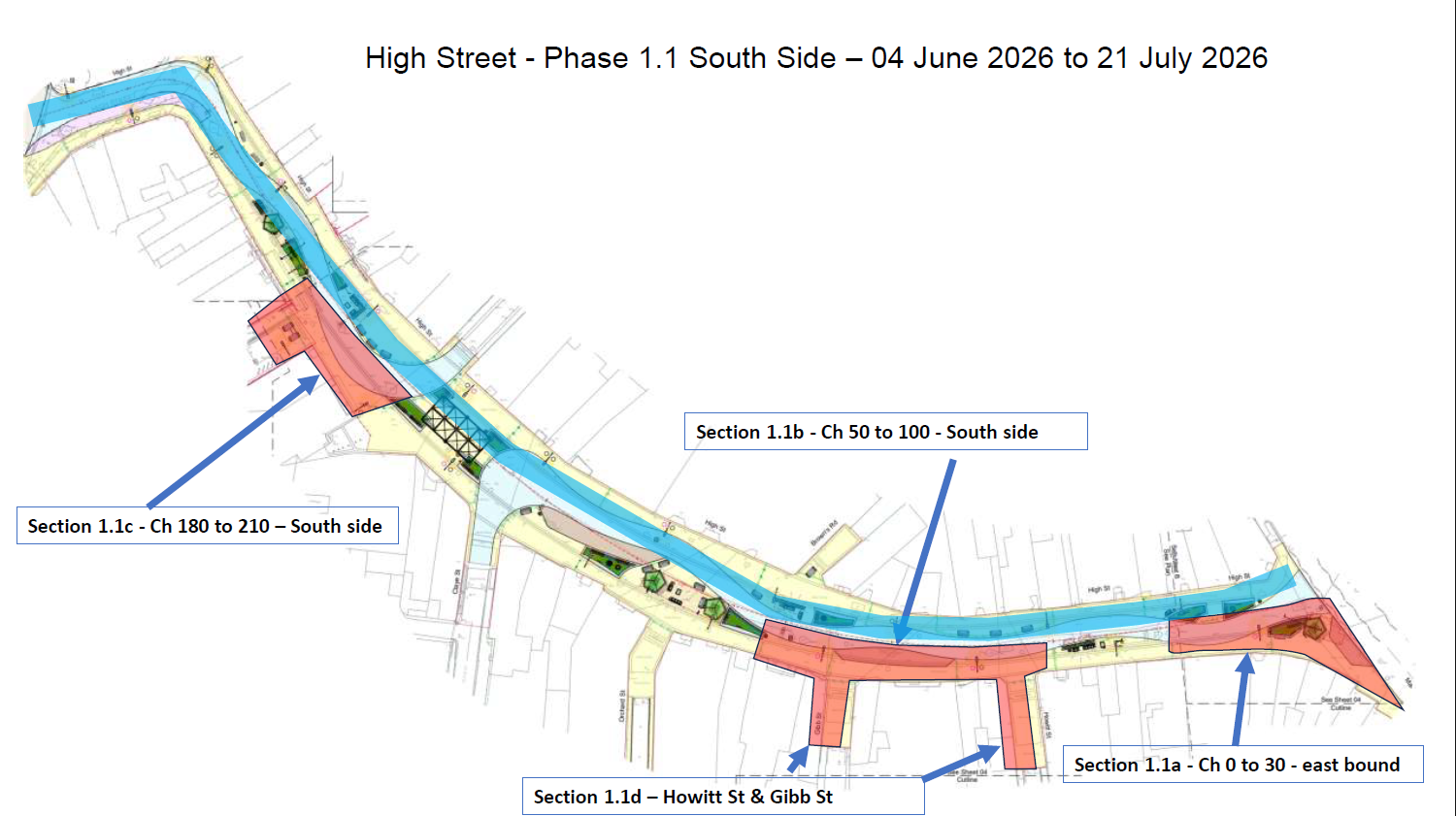

- Major works on the High Street will begin on the 4th of June 2026 and are scheduled to end in March 2027.

- Major works on Tamworth Road will begin in June 2026 and are scheduled to end in November 2026.

- The final part of the work, on the Back Market adjacent to Beaconsfield Street car park is scheduled to end in March 2027.

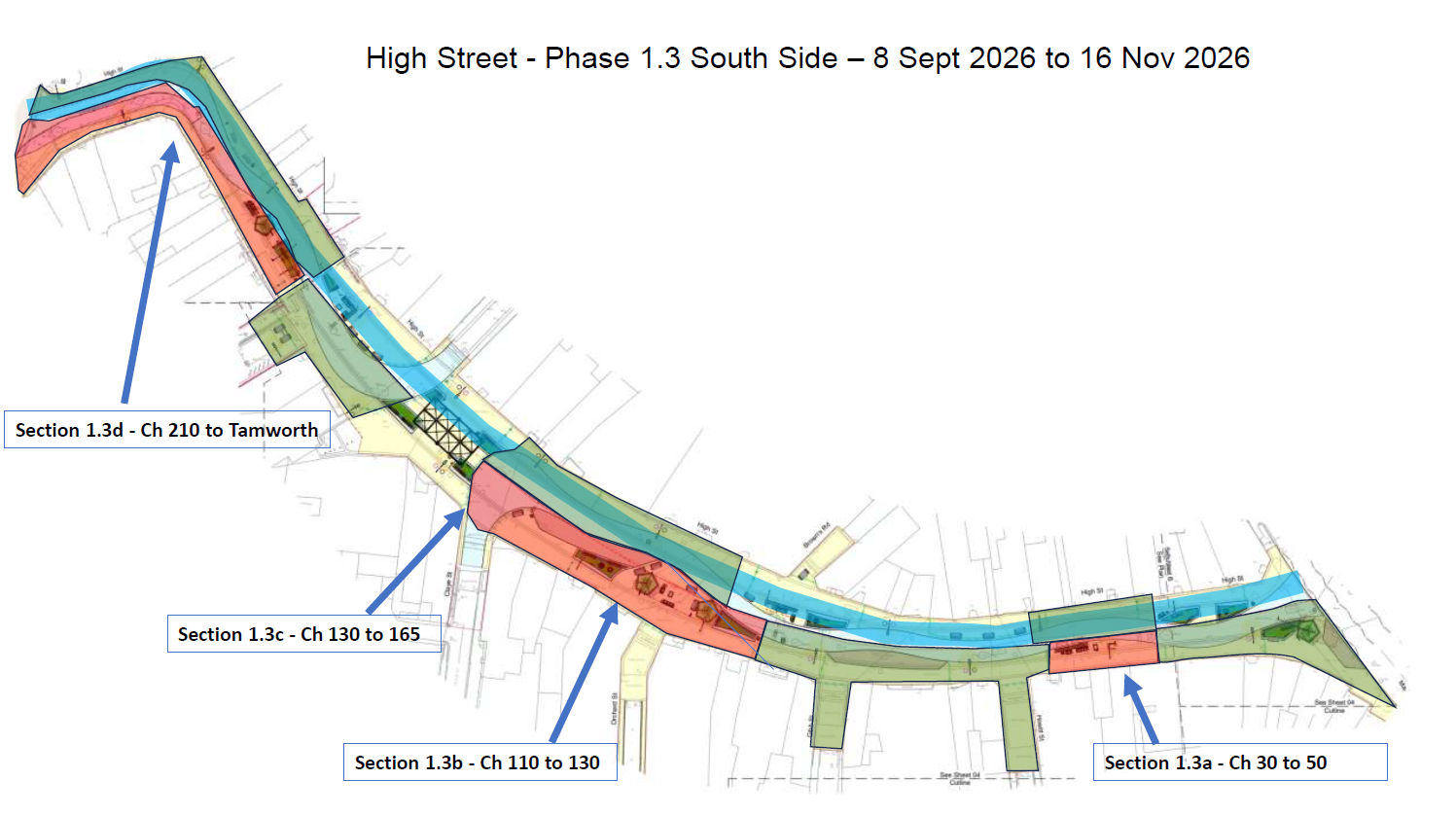

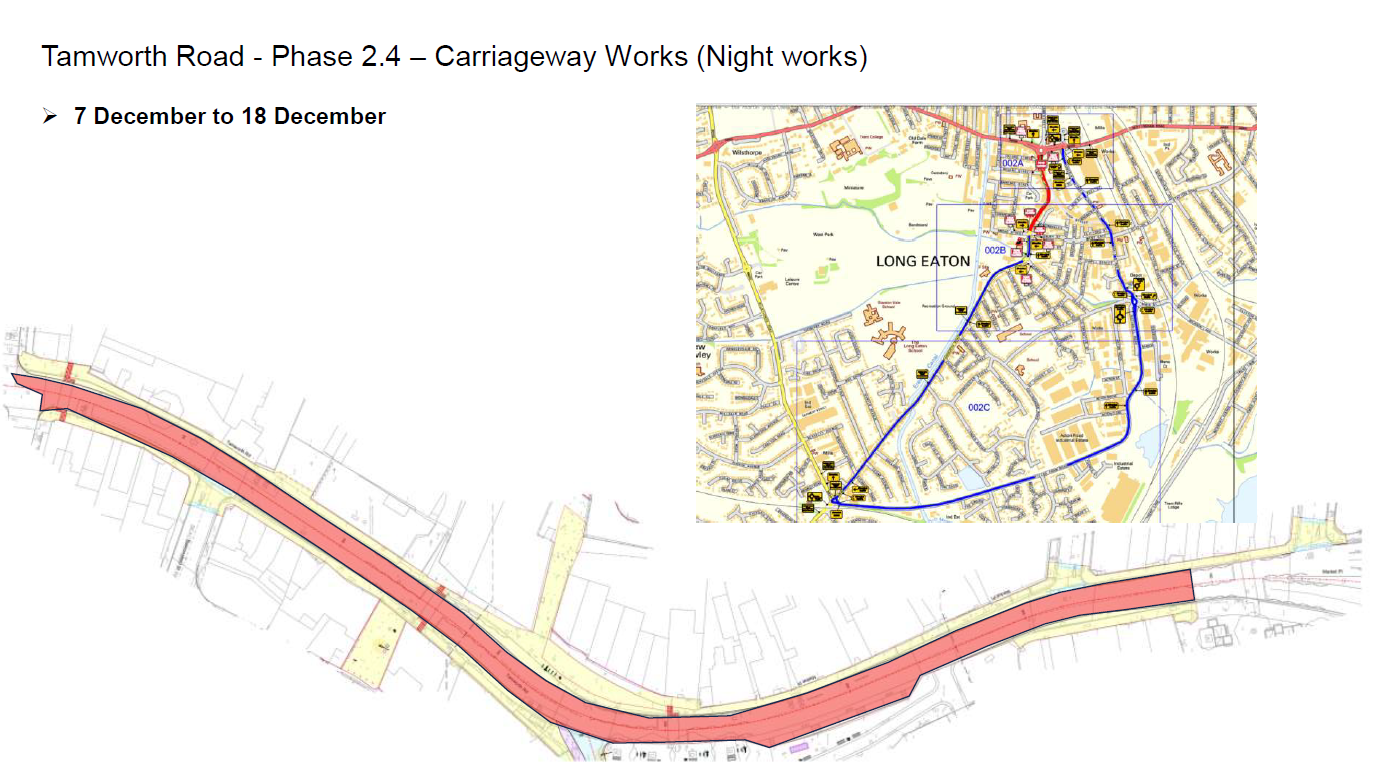

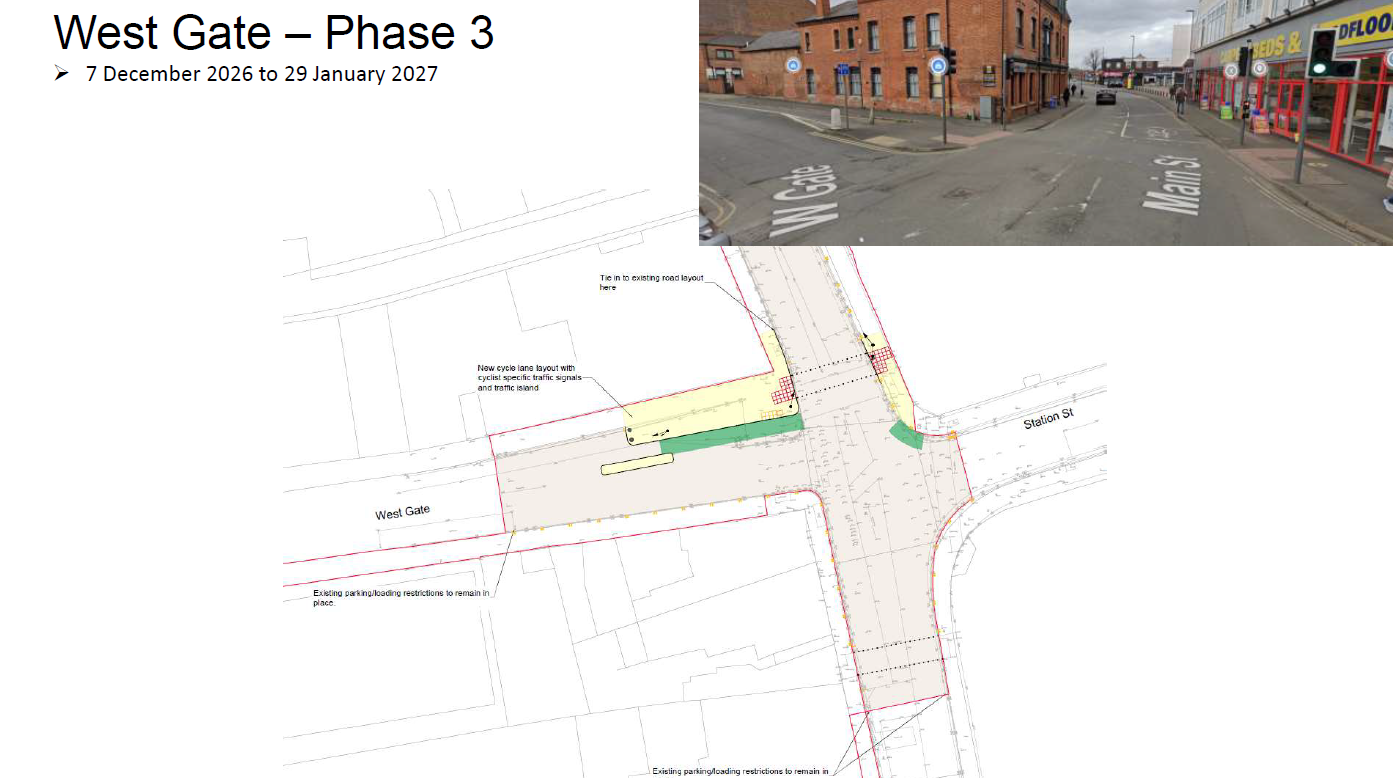

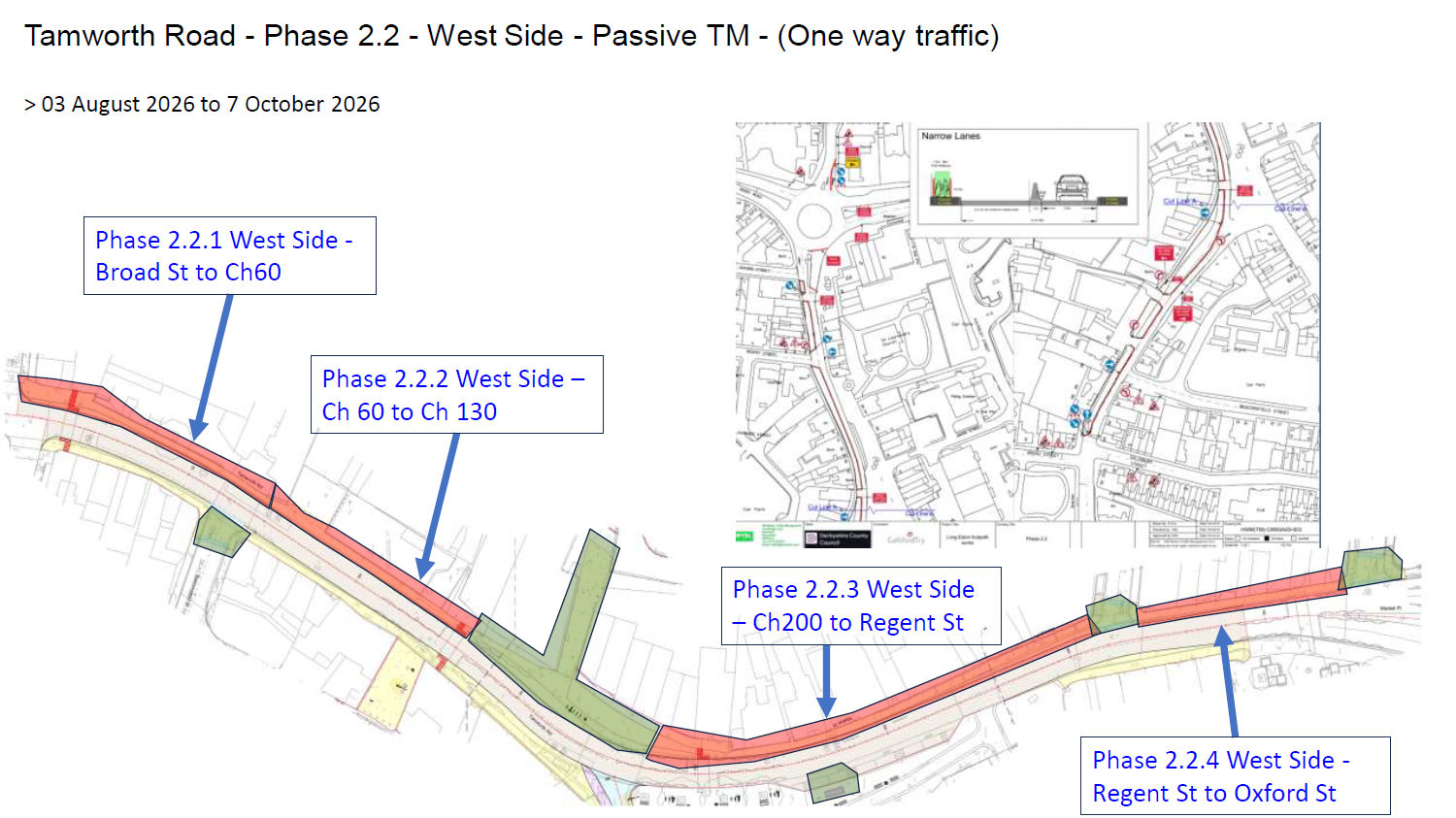

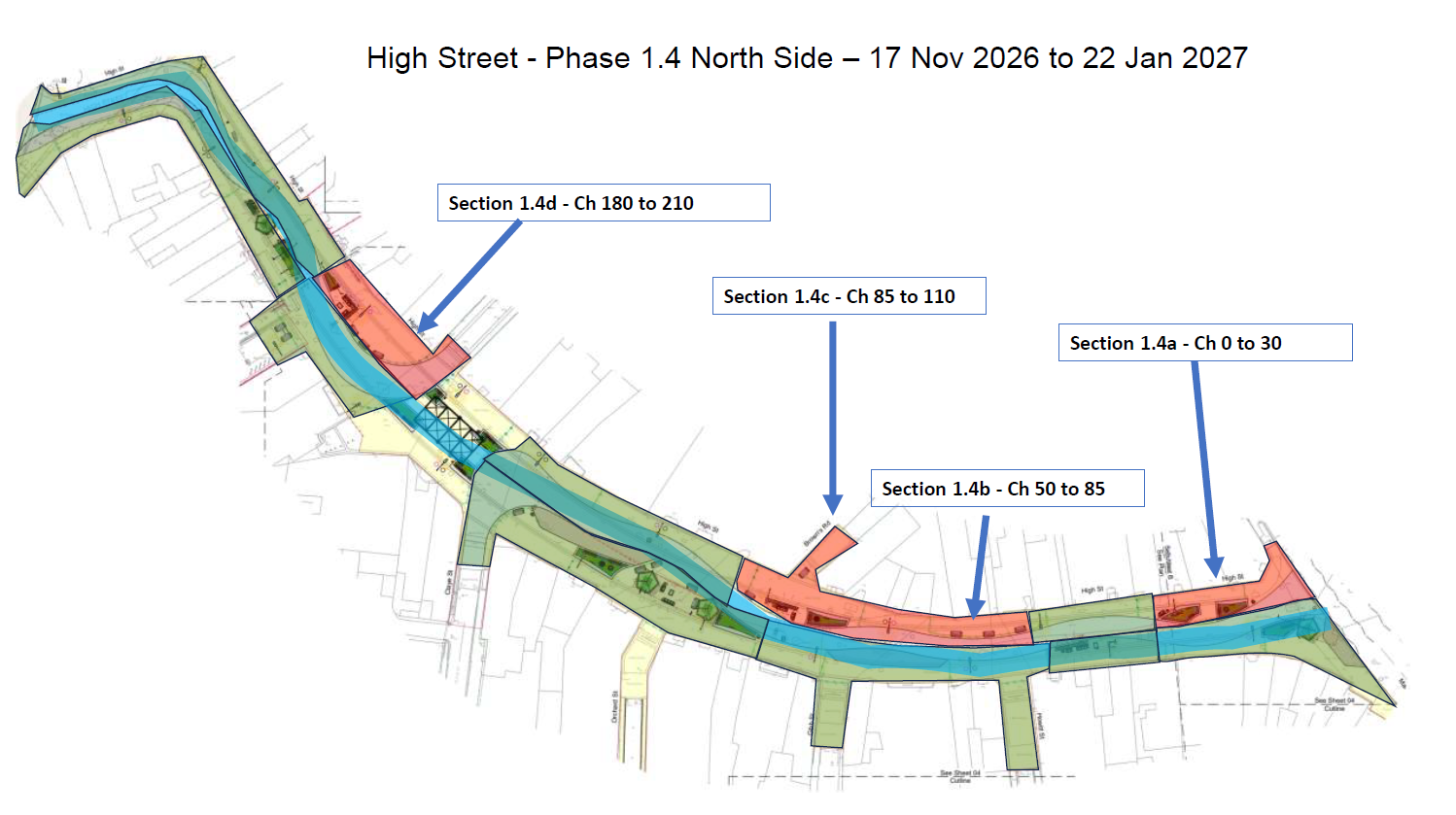

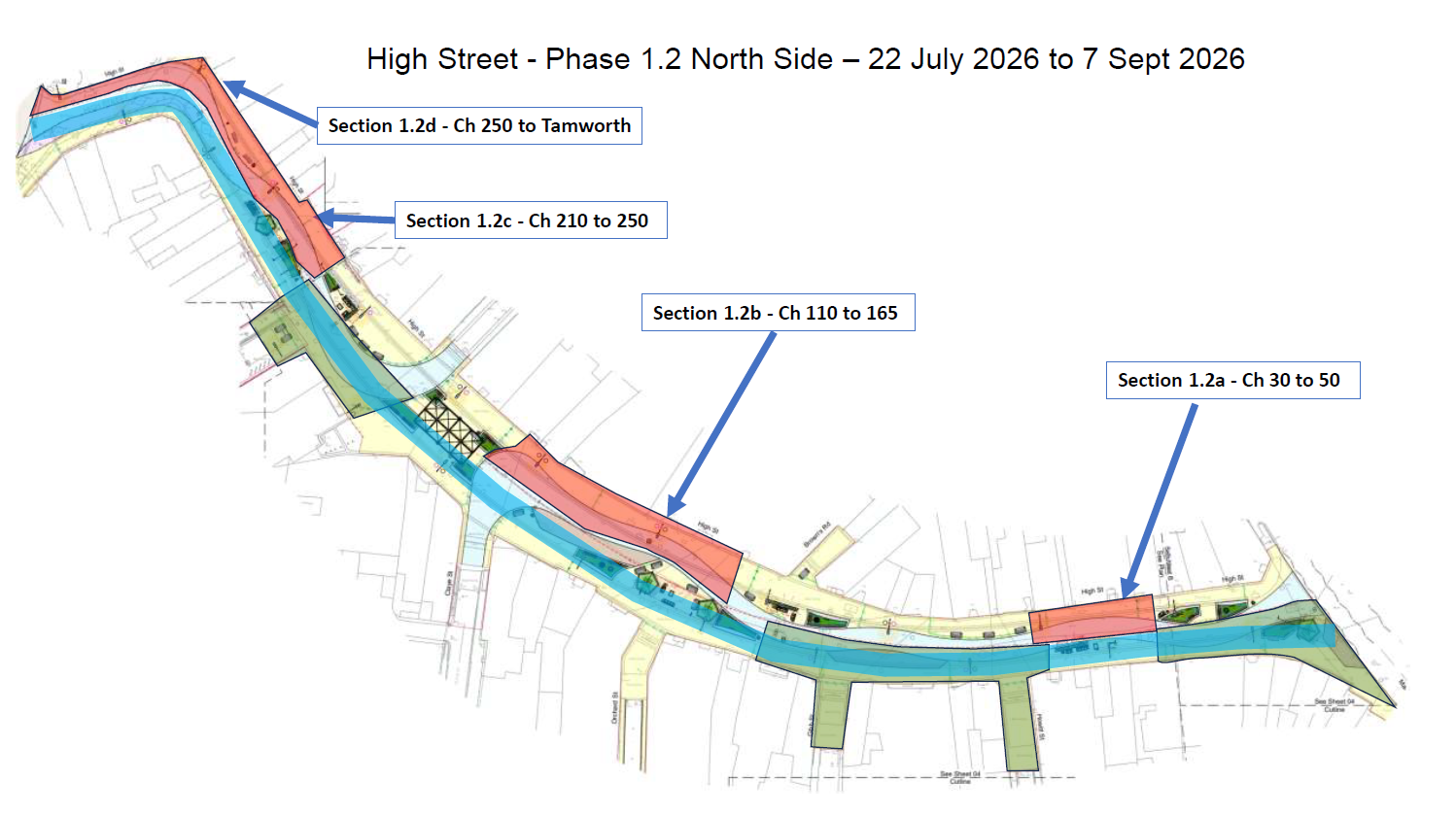

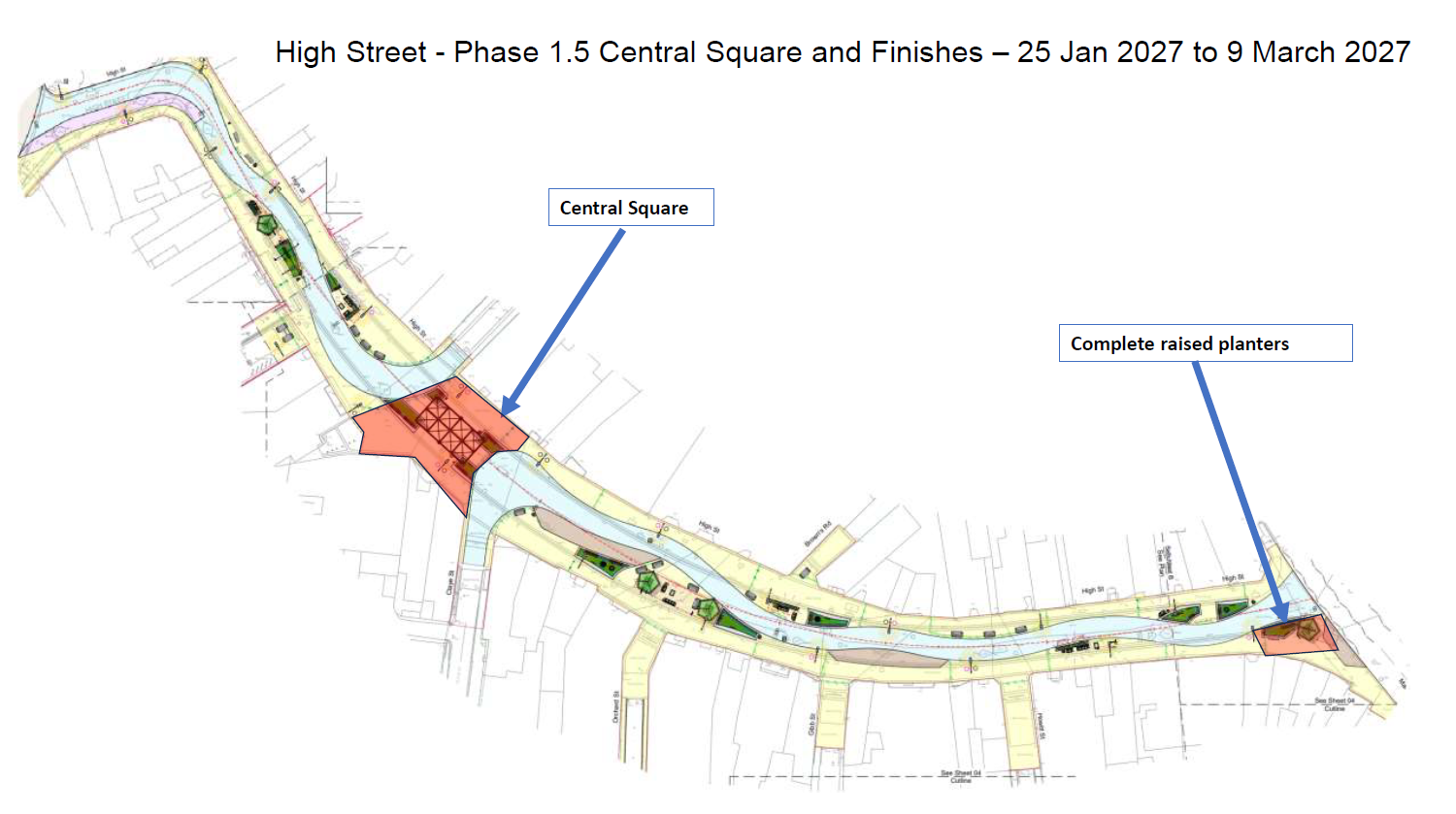

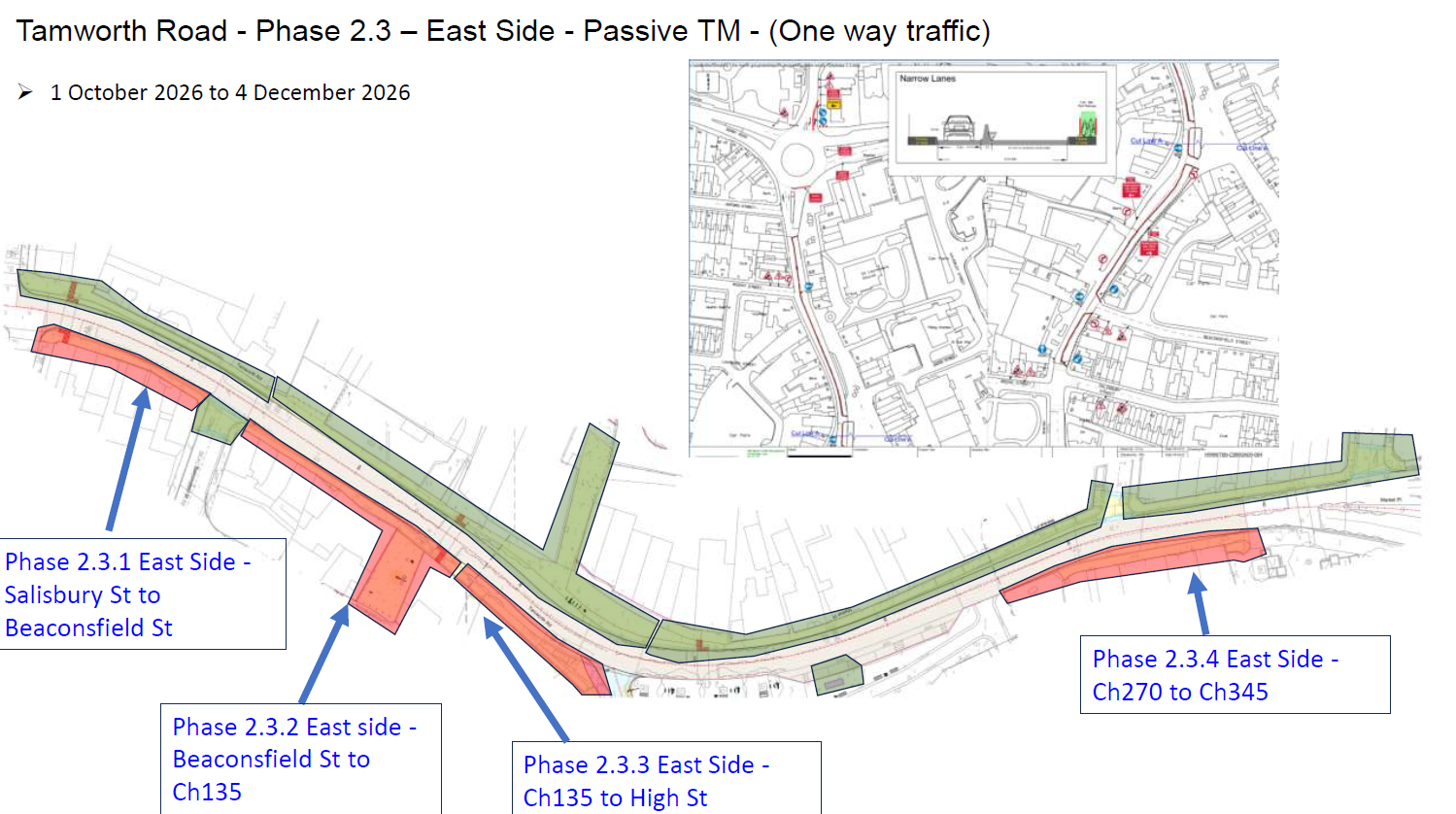

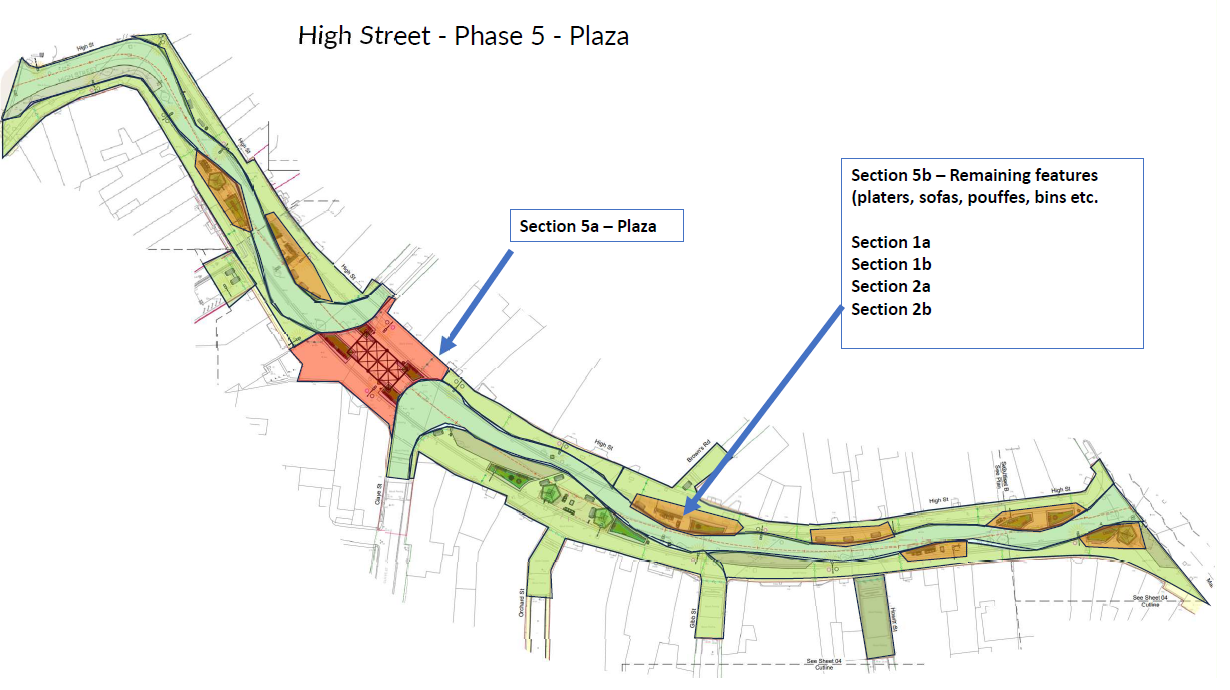

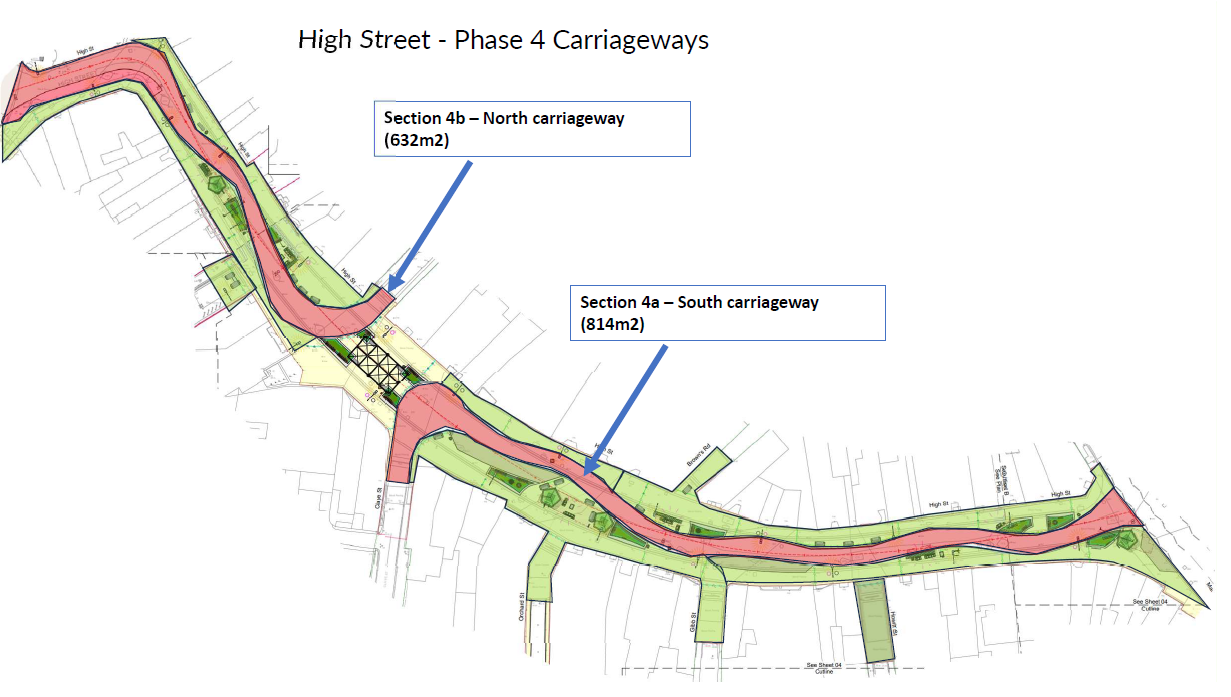

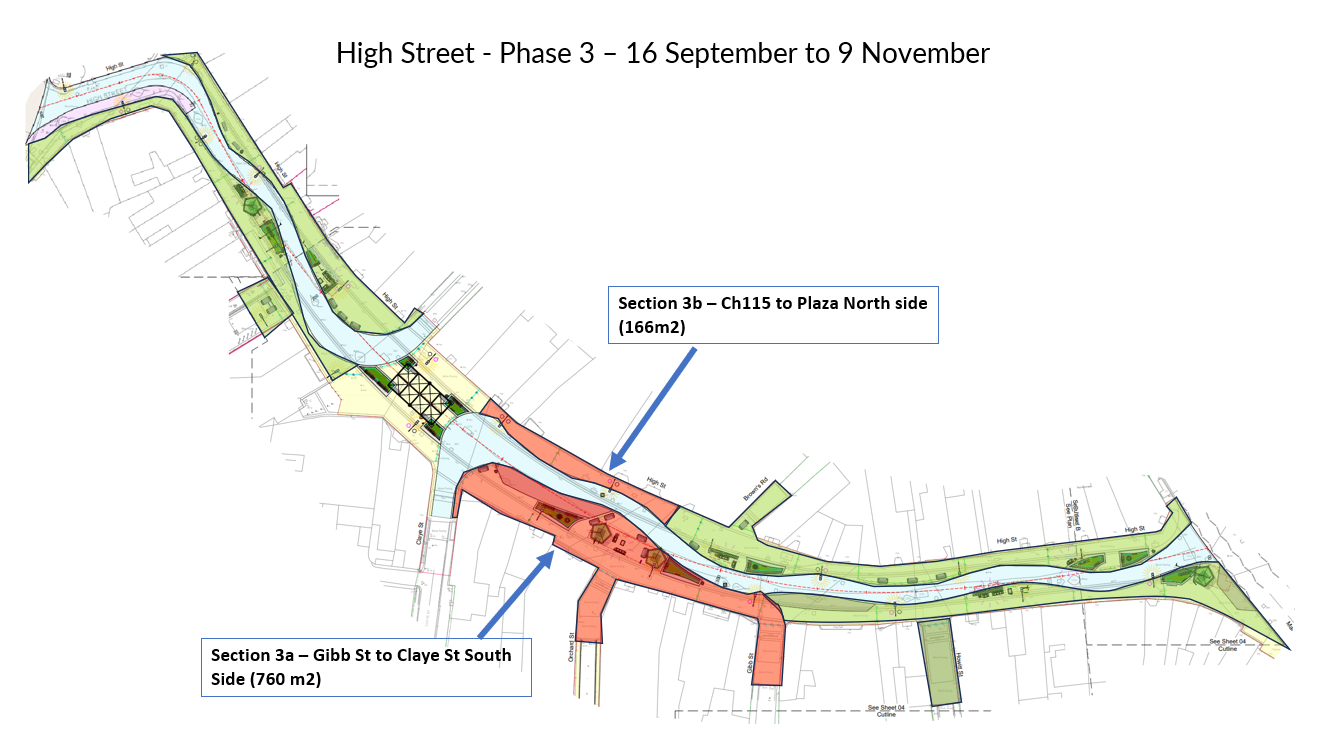

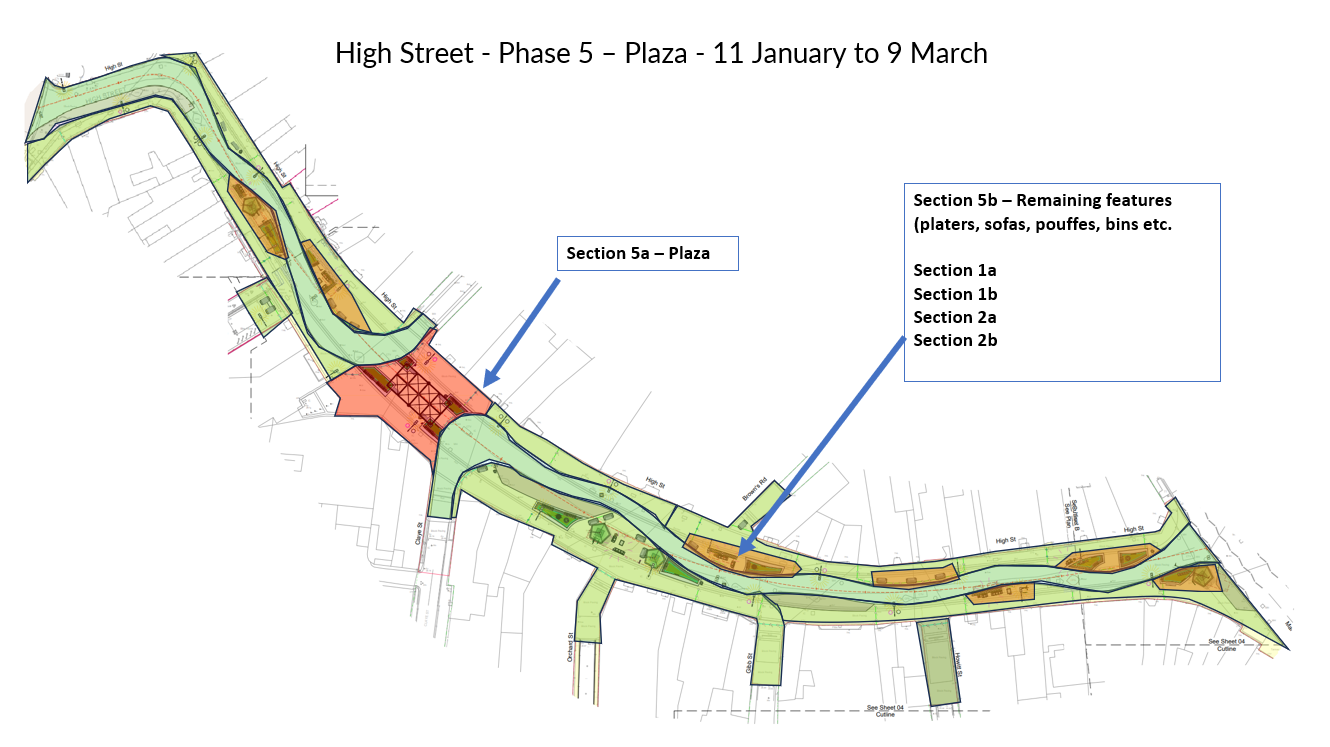

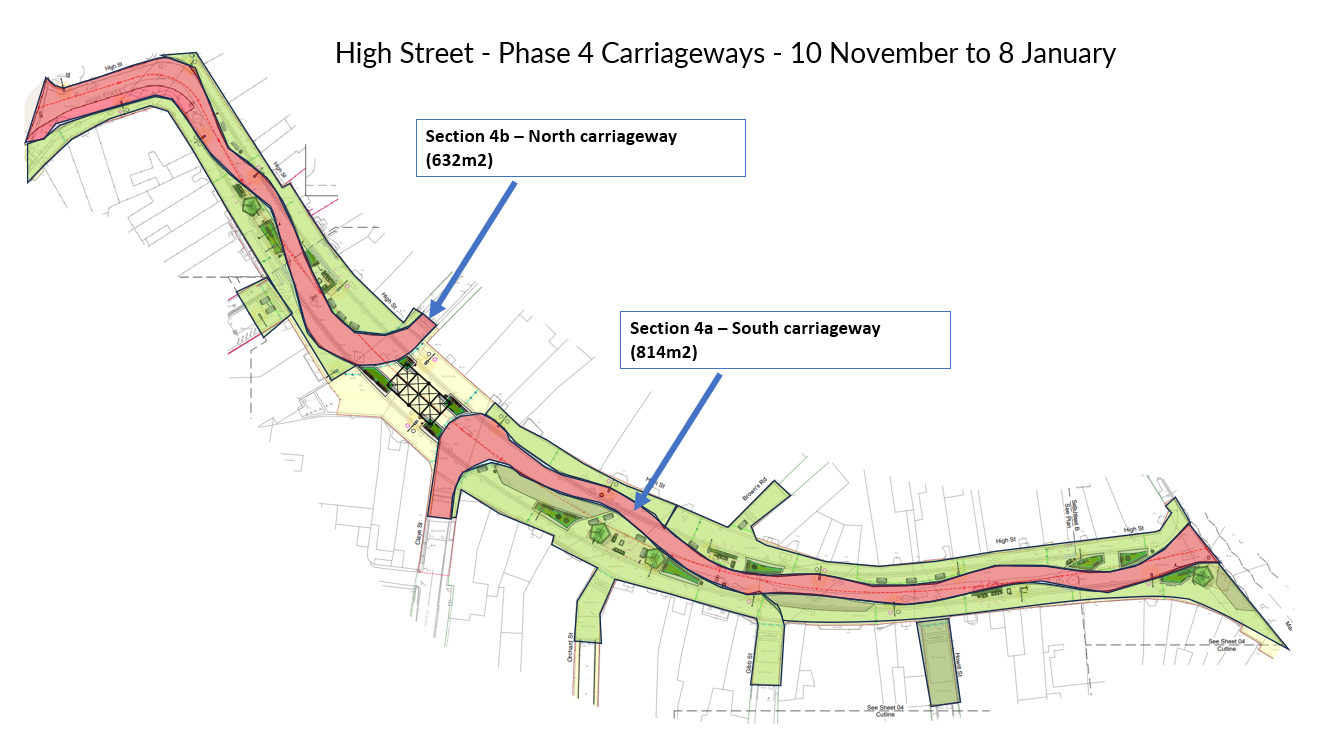

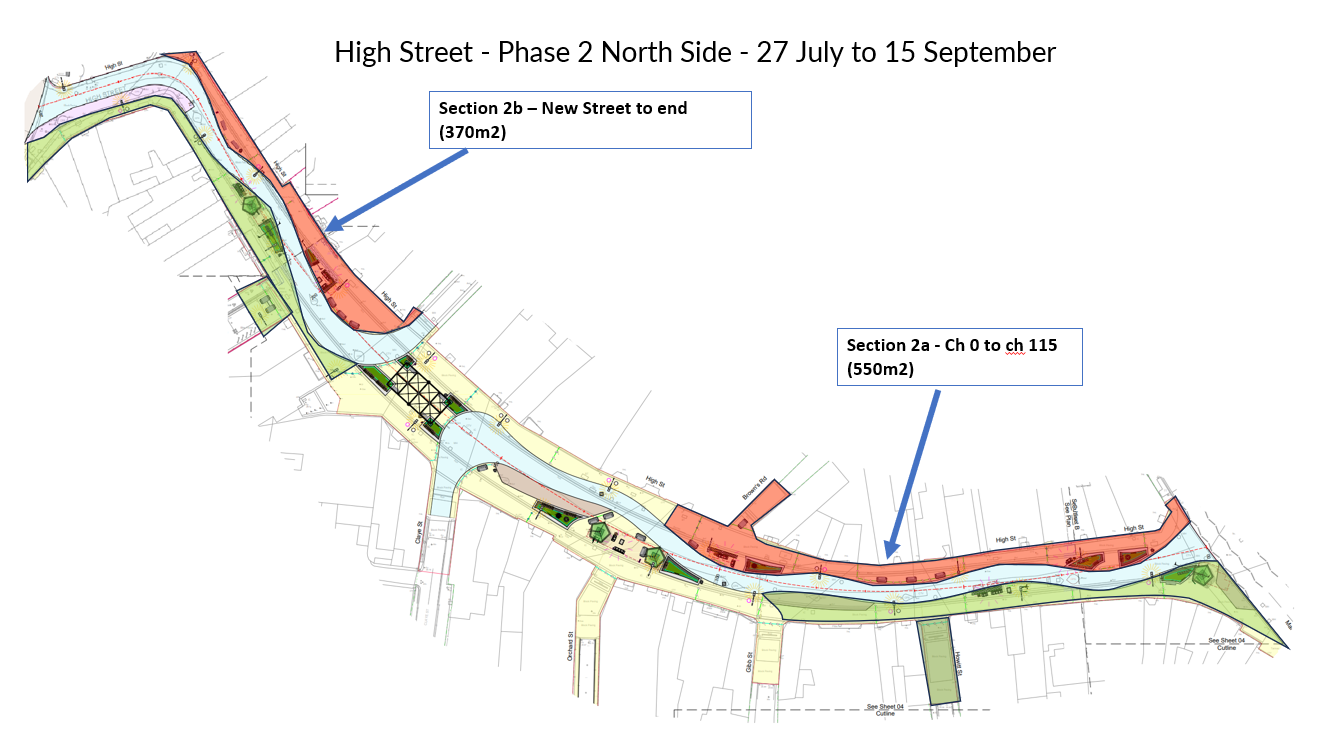

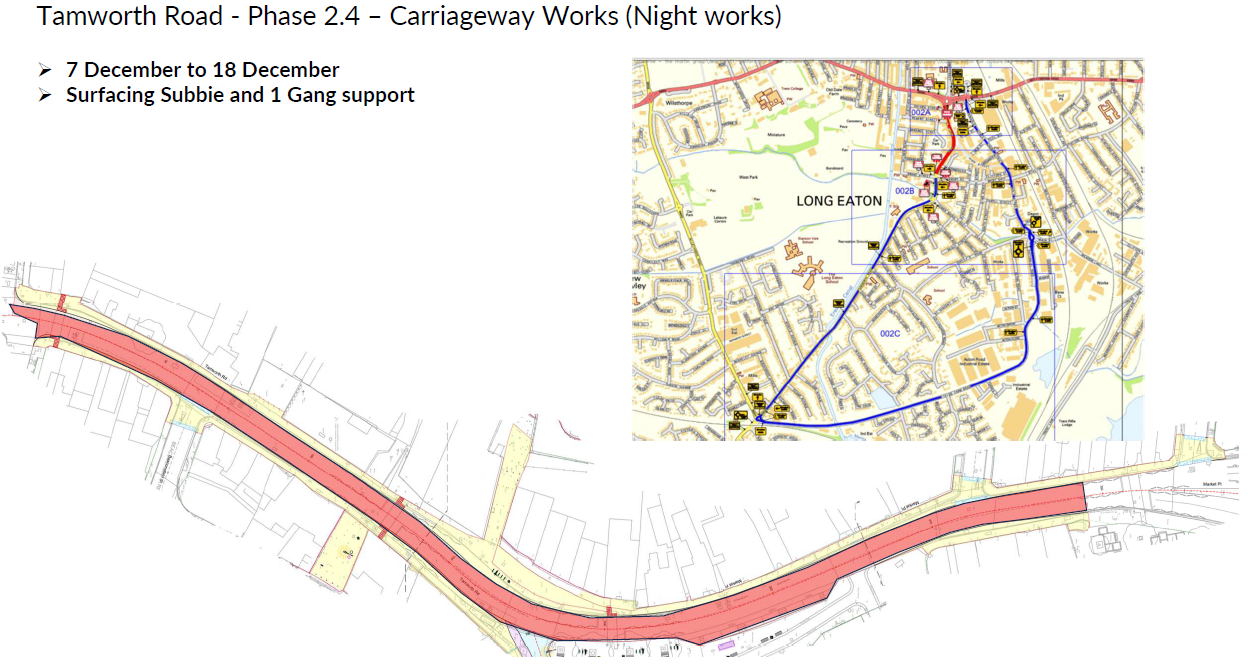

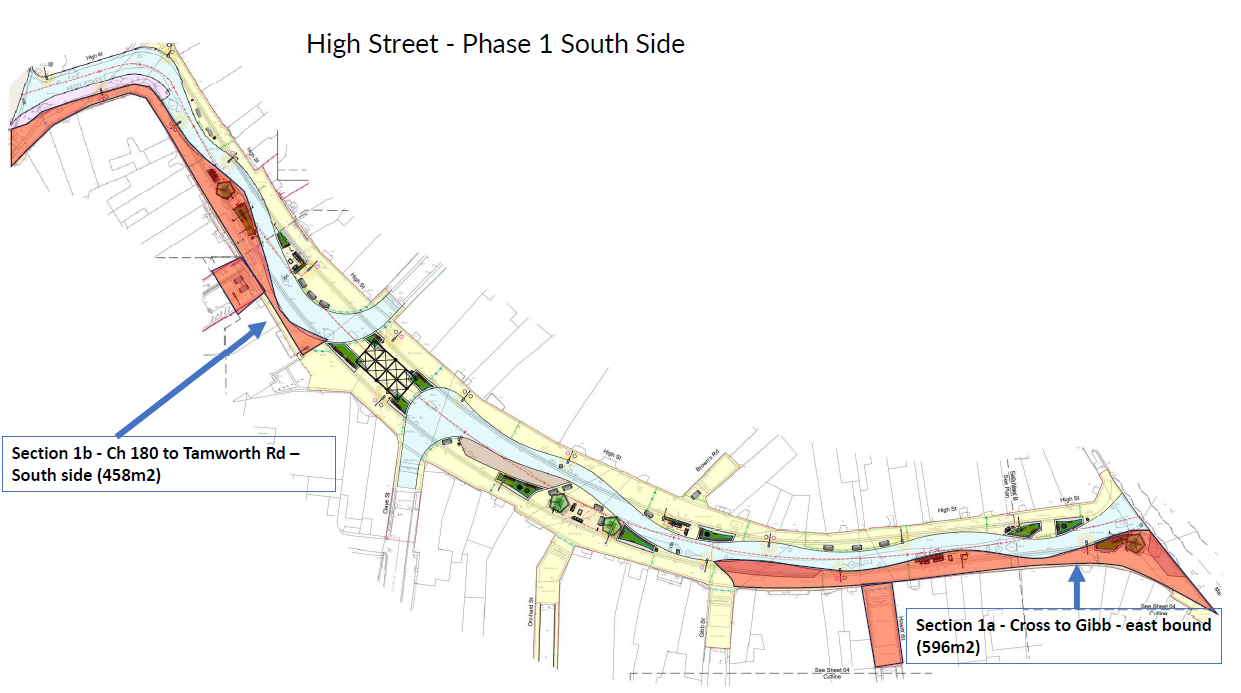

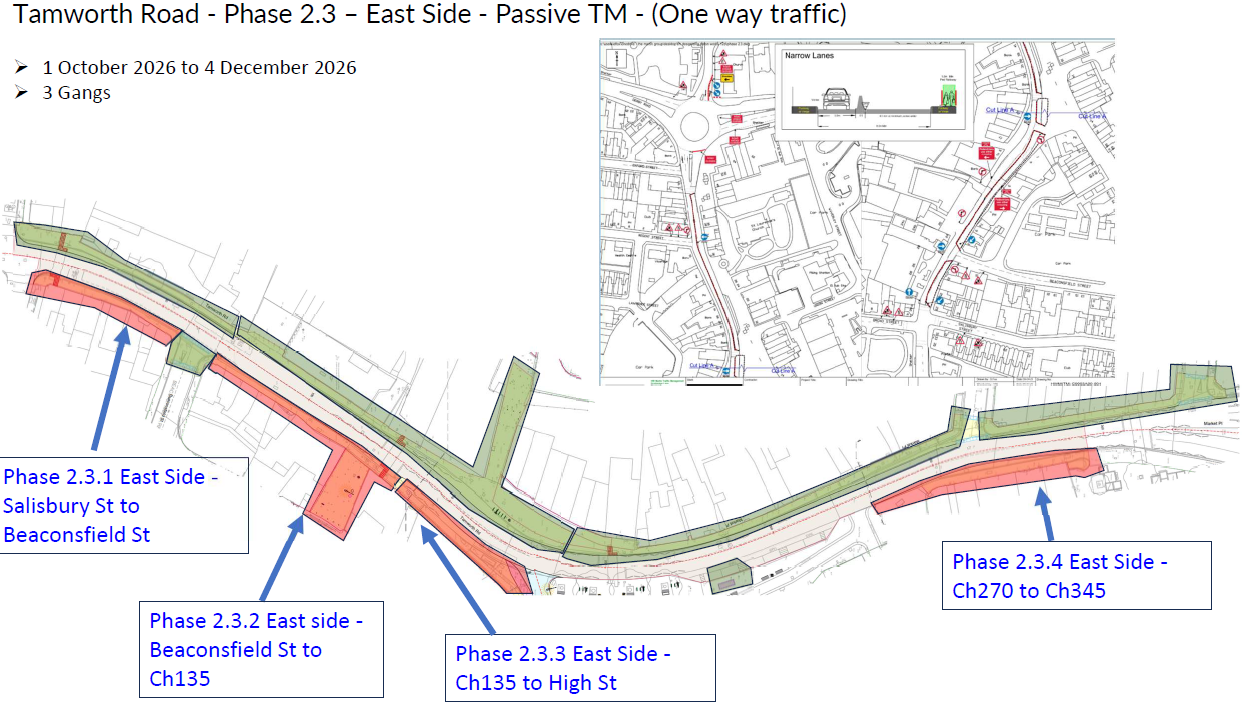

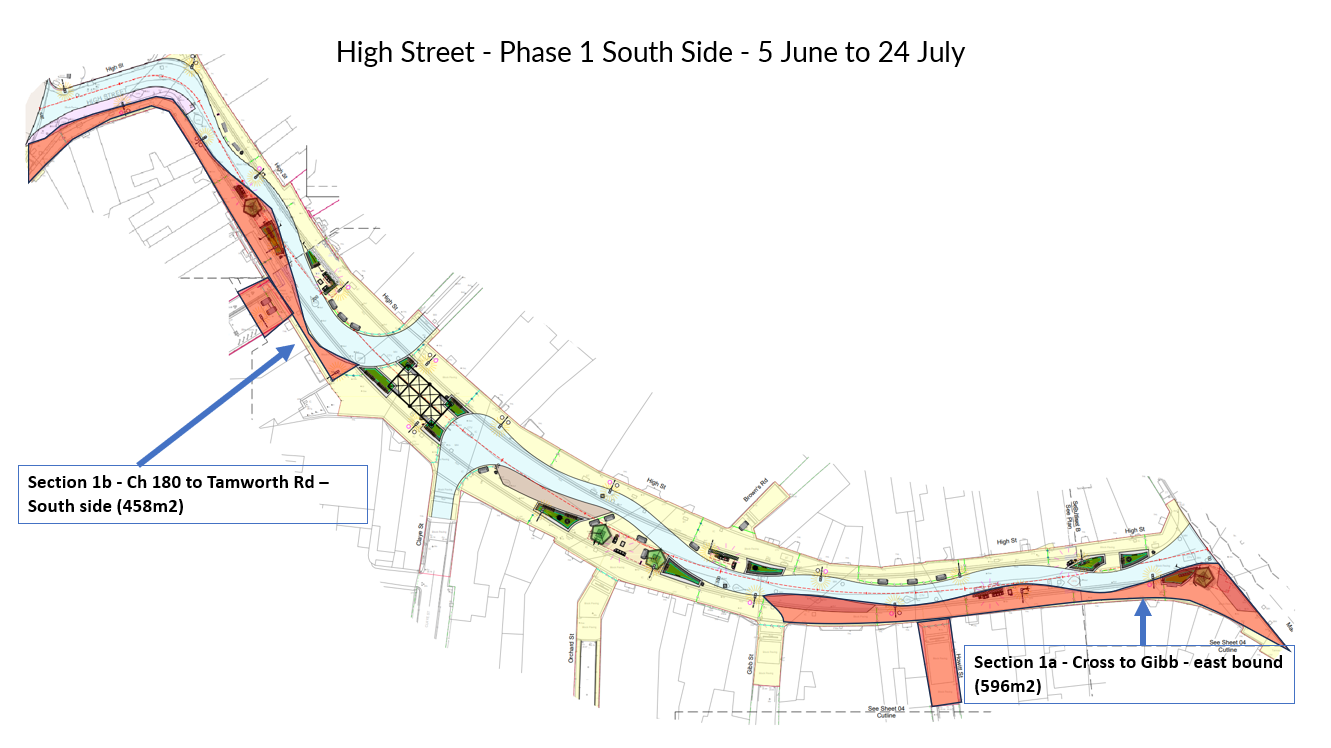

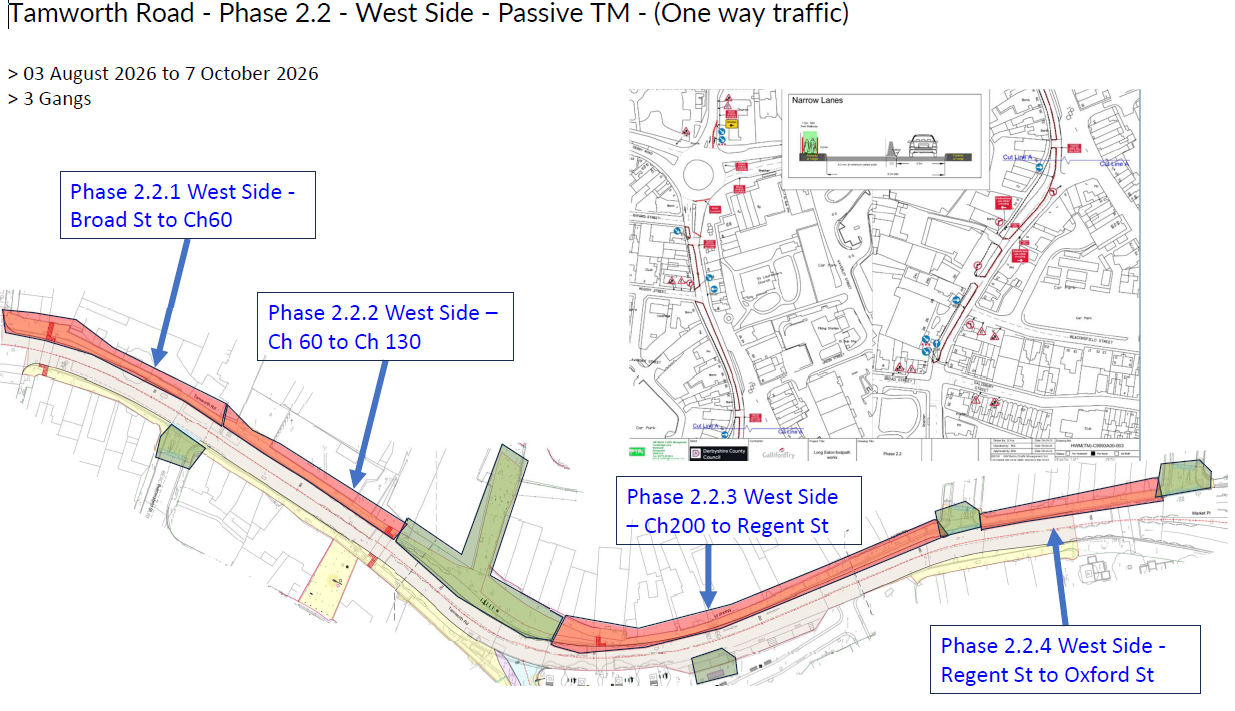

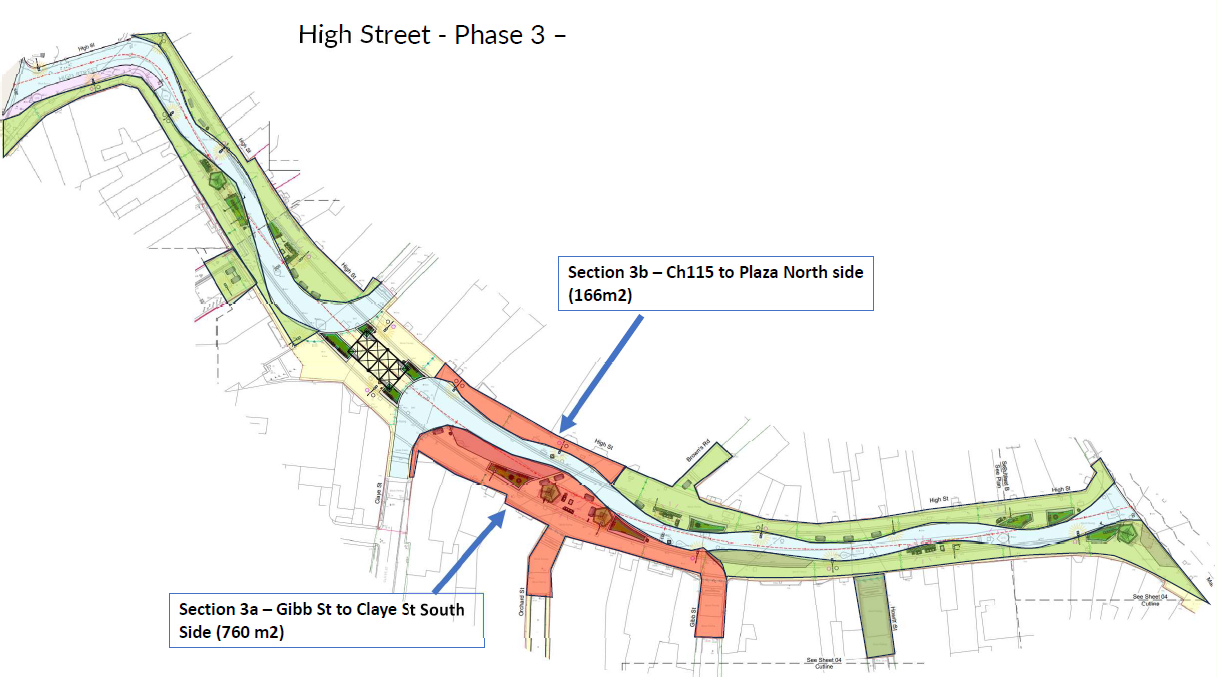

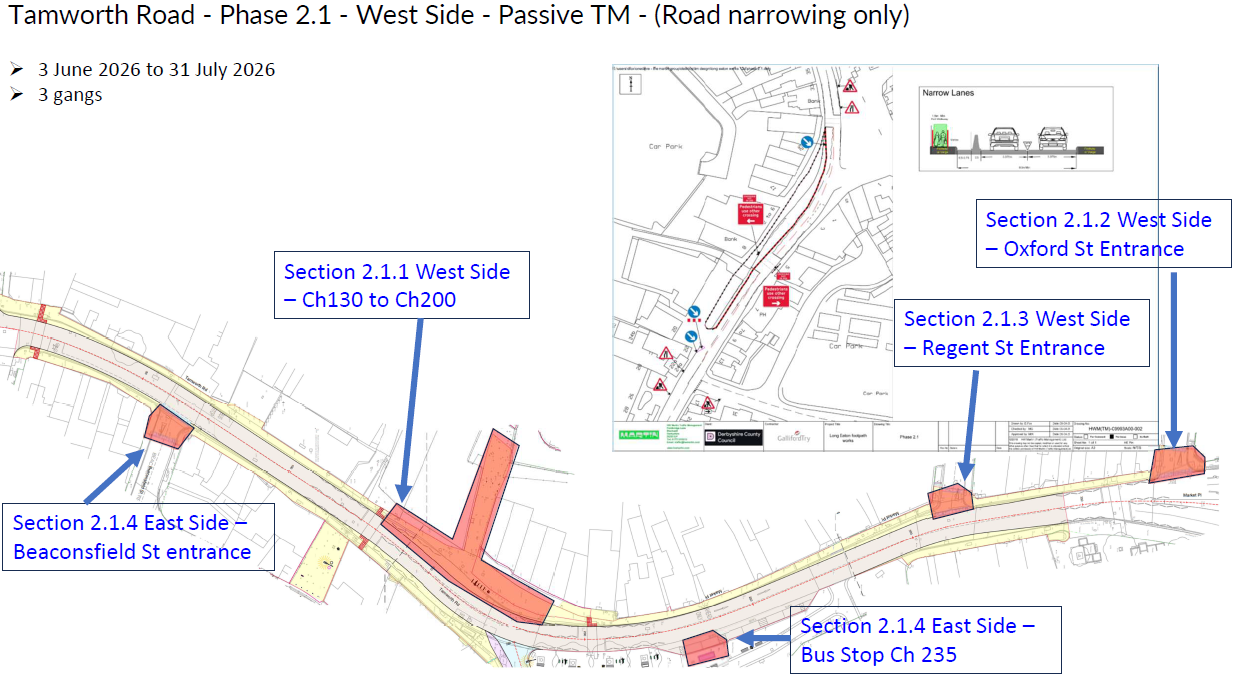

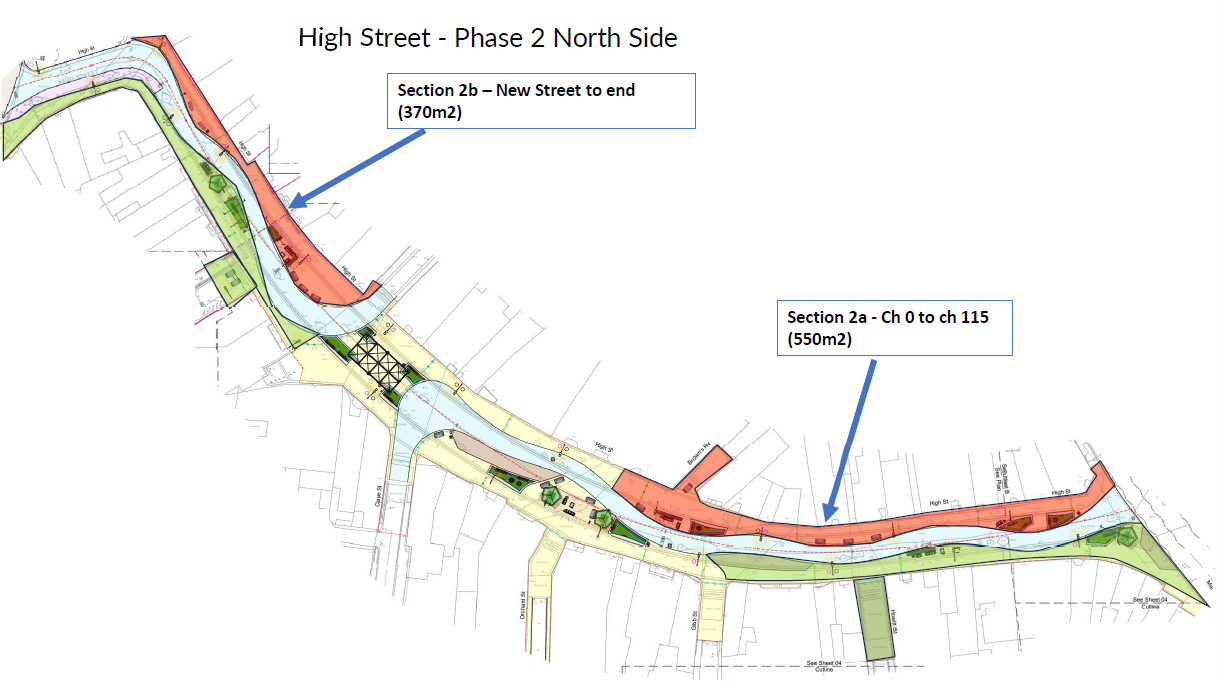

You can see the phasing plan below, which shows when the phases of work will begin and end. The areas shaded in red show where work will be happening between the specified dates and areas shaded in green show where work will have been completed before the specified dates. If you would like help understanding where your business sits within this plan, please send us your business address via this contact form and we will advise you when work is scheduled to start and end near your business.
Please note that the dates below may change as work progresses. This webpage is being kept up to date to reflect any changes to the plans, these latest plans were uploaded on 07/07/2026.
